AI Computing Power Gap: How Token Consumption is Reshaping Server Component Sourcing

Published: 23 June 2026 | Last Updated: 23 June 202633
As global token consumption drives the transition to high-density 100kW+ AI data centers, power delivery networks require advanced Wide-Bandgap semiconductors (SiC/GaN) and high-capacitance MLCCs. This shift has triggered a component procurement crisis with lead times exceeding 24 weeks. To bypass shortages, hardware buyers must abandon just-in-time manufacturing and leverage independent global distributor networks to secure critical power and passive components.

The exponential rise of Large Language Models (LLMs) and autonomous AI agents has created a massive global AI computing power gap. As software demands outpace traditional hardware capabilities, data center infrastructure is undergoing a radical physical transformation. Hyperscalers are racing to deploy high-density, 100kW+ racks, fundamentally breaking legacy power distribution and thermal management models. For hardware procurement managers and power supply engineers, this architectural shift translates into a severe supply chain reality: unprecedented demand for Wide-Bandgap (SiC/GaN) power devices, High-Capacitance MLCCs, and Power Management ICs (PMICs), resulting in lead times stretching beyond 24 weeks.

This article analyzes the engineering constraints driving next-generation AI server designs and provides actionable sourcing strategies for B2B buyers navigating the 2026 component squeeze.

The Macro Driver: 24x Token Growth and the "Tokens per Watt" Era

The root cause of the current hardware shortage is software consumption. According to market projections from Goldman Sachs, global AI token consumption is expected to surge 24 times by 2030, driven heavily by the enterprise adoption of autonomous AI agents. This software reality is forcing a paradigm shift in how data centers measure efficiency.

Historically, infrastructure planners measured capacity in "kW per rack." Today, the industry is shifting to a "Tokens per Watt" metric to align infrastructure design with actual AI compute output. This massive computing power demand is driving AI-related capital expenditures for super-large data centers to an estimated $110 billion to $140 billion by 2027. The resulting supply and demand imbalance is already causing delays in data center projects, as physical resources—specifically electricity and specialized electronic components—become the ultimate bottlenecks.

The Physical Reality of 600kW Racks

Average data center rack density has historically hovered around 10 to 27 kW. AI workloads have pushed this into warp speed. NVIDIA’s GB200 NVL72 rack pushes power requirements to 120kW, and the upcoming NVIDIA Rubin Ultra NVL576 architecture is projected to approach a staggering 600 kW per rack by the second half of 2027.

At these densities, traditional airflow cooling and standard AC power distribution completely fail. While liquid cooling (rear door heat exchangers and immersion) frequently dominates the thermal conversation, power distribution is the equally critical, often-overlooked twin constraint. Delivering 600kW of power to a single rack without melting the infrastructure requires a complete redesign of the Power Delivery Network (PDN).

Engineering the Power Delivery Network: SiC, GaN, and HVDC

High-performance AI GPUs now draw 1,000W to 2,000W each. To support this, server Power Supply Units (PSUs) must scale from legacy 800W levels to 5.5kW, 8kW, and even 12kW.

Traditional silicon MOSFETs have reached their physical performance and efficiency ceilings for these high-frequency, high-density workloads. To manage the thermal and electrical loads, data centers are shifting toward 800V High-Voltage Direct Current (HVDC) architectures. This eliminates multiple AC-DC conversion steps, increasing transmission capacity by 85%.

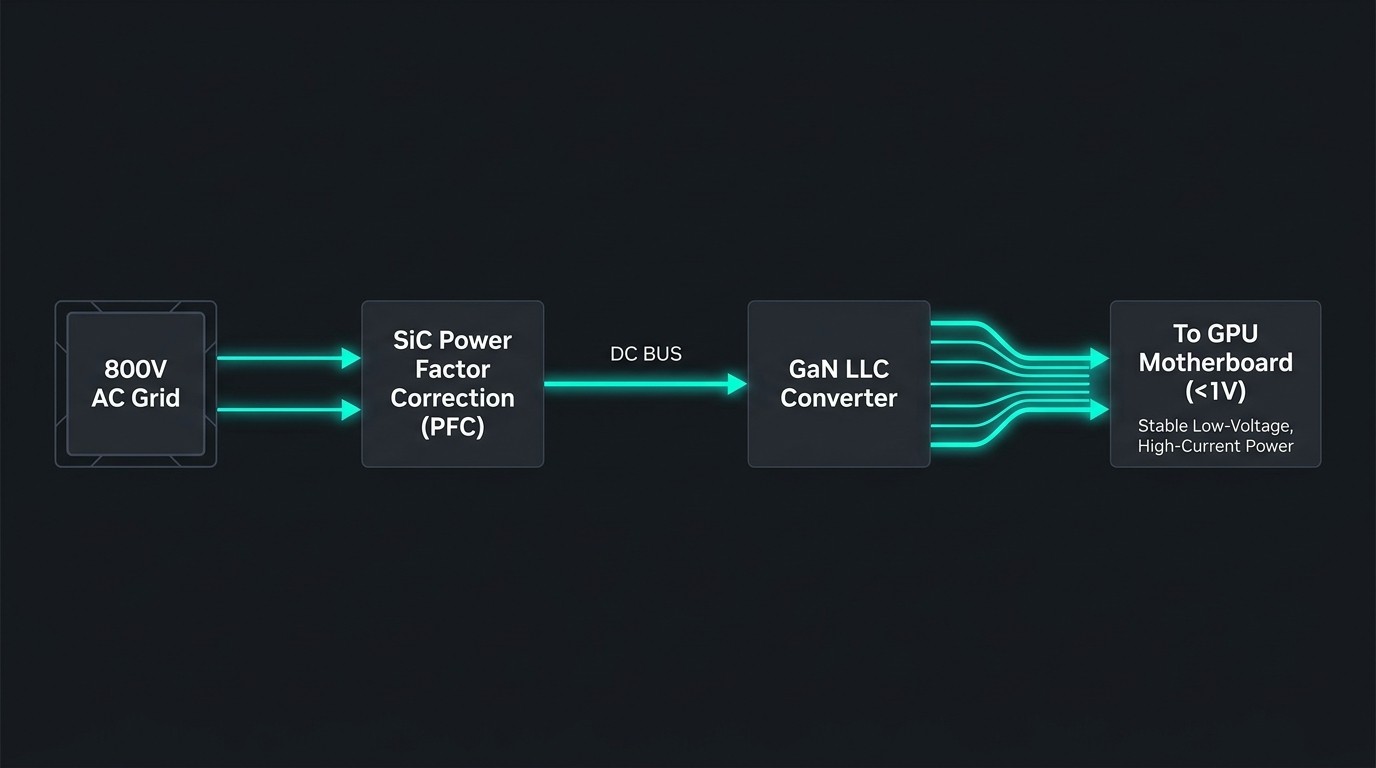

800V HVDC Power Delivery Network with SiC and GaN Stages.jpg
800V HVDC Power Delivery Network with SiC and GaN Stages

This architectural shift makes third-generation Wide-Bandgap (WBG) semiconductors mandatory. Silicon Carbide (SiC) and Gallium Nitride (GaN) offer lower on-resistance, higher switching speeds, and reduced thermal losses. Next-generation 8kW PSUs utilize a mix of SiC (for Power Factor Correction stages) and GaN (for LLC converter stages) to achieve 97.5% efficiency and 100 W/in³ power density. By minimizing switching losses, WBG materials allow engineers to shrink magnetic components and manage thermals within the rack's strict physical footprint.

📺 Local AI Explained | Hardware, Setup and Models

The MLCC Explosion: Buffering Sub-1V GPU Current Spikes

While power semiconductors act as the "gatekeepers" of electricity from the grid to the motherboard, passive components are the critical final mile. AI GPUs operate at sub-1V levels but experience instantaneous current changes of hundreds to thousands of amperes depending on the token workload.

To prevent system crashes during heavy inference or training, high-capacitance MLCCs with low Equivalent Series Resistance (ESR) must be placed extremely close to the GPU. They act as rapid current buffers and suppress broadband power noise.

The volume required is staggering. A single standard AI server requires 15,000 to 20,000 high-capacity MLCCs—roughly 3 to 5 times more than traditional servers. Recent teardowns reveal that NVIDIA Rubin racks require over 600,000 capacitors, with the total value of MLCCs per rack surging to $4,320 (a 182% increase from the previous generation).

GPU Motherboard Layout MLCC Buffering Placement.jpg
GPU Motherboard Layout: MLCC Buffering Placement

Edge Alternatives: Bypassing the VRAM Bottleneck with Unified Memory

For enterprise builders who cannot secure or afford $7,000+ traditional GPUs (like the 48GB RTX 6000 Ada) to bridge their local AI computing power gap, the industry is pivoting toward Unified Memory Architectures at the edge.

Recent hardware demonstrations of AMD's "Strix Halo" processors reveal how edge devices are bypassing the VRAM bottleneck. Instead of isolated CPU and GPU memory pools separated by PCIe lanes, these systems utilize a massive 128GB unified memory pool. By applying specific Linux OS kernel modifications (such as tweaking the GRUB configuration with amdgpu.gttsize=108000), engineers can force the OS to allocate up to 108GB of system RAM directly to the GPU for local LLM inference.

However, engineers testing these local deployments warn of the "KV Cache memory trap." When sizing hardware for local inference, buyers often calculate the VRAM needed for the model weights but forget the memory required for the context window (Key-Value cache). Squeezing a 101GB quantized model into 108GB of allocated memory leaves room for only a tiny ~4,000 token context window before the system bottlenecks, highlighting why high-capacity memory components remain critical even in edge deployments.

The 2026 Procurement Crisis: Navigating the "Two-Tier" Market

The engineering demands of 100kW+ racks have created a "K-shaped" or two-tier component market. While standard consumer electronics components remain stagnant, AI and automotive-grade high-end components face severe shortages. Hyperscalers with deep pockets are absorbing massive foundry capacity, leaving mid-tier enterprise buyers stranded.

According to industry data, lead times for power semiconductors and PMICs from major IDMs have stretched to 35–40 weeks. Simultaneously, top-tier suppliers are reallocating capacity away from industrial sectors to serve AI hyperscalers, driving 10-15% YoY price hikes for high-cap MLCCs.

To navigate these 2026 semiconductor and electronic components price trends, procurement teams must abandon just-in-time (JIT) manufacturing models. Securing inventory requires proactive sourcing tactics amid price hikes and lead time extensions, including qualifying secondary suppliers and leveraging independent global distributors.

2026 Component Sourcing Lead Times Analysis.jpg
2026 Component Sourcing Lead Times Analysis

For procurement teams facing these constraints, UTMEL Electronics offers an extensive, verified global supplier network to source high-demand active and passive components—including PMICs, high-capacitance MLCCs, and SiC/GaN devices. By tapping into a verified independent network, data center builders can bypass standard 24-week lead times and secure their supply chains during the AI-driven component squeeze.

Component Sourcing Decision Matrix

Use this matrix to align your procurement strategy with the specific lead-time risks of AI server components.

Component CategoryAI Server FunctionCurrent Lead Time RiskSourcing Strategy & Mitigation
High-Capacitance MLCCs (X5R/X7R)Sub-1V GPU current buffering; noise suppression.High (20+ weeks)Stockpile 6 months out. Qualify alternative tier-2 manufacturers; utilize independent verified distributors.
SiC / GaN Power DevicesHigh-efficiency switching for 5.5kW+ PSUs and HVDC.Critical (35-40 weeks)Lock in long-term NCNR (Non-Cancellable, Non-Returnable) contracts. Redesign boards to accept multiple footprint-compatible WBG brands.
Power Management ICs (PMICs)Voltage regulation across 48V to sub-1V step-downs.Critical (35-40 weeks)Avoid single-source proprietary PMICs where possible. Leverage global supplier networks to find excess hyperscaler inventory.
Standard Silicon MOSFETsLegacy power control and lower-density server racks.Low to Medium (8-12 weeks)Maintain standard JIT inventory, but monitor for foundry capacity shifts as manufacturers prioritize WBG production.

What to Ignore in the 2026 AI Hardware Market

  • Consumer-Grade Component Metrics: Ignore standard consumer MLCC or silicon MOSFET availability reports. The market is "K-shaped." An oversupply of smartphone capacitors does not equate to availability for high-voltage, high-temperature AI-grade MLCCs.

  • Pure Liquid-Cooling Tunnel Vision: Ignore infrastructure pitches that focus only on liquid cooling. Thermal rejection is only half the battle; if your Power Delivery Network (PDN) still relies on legacy AC-DC conversion and standard silicon, your rack will bottleneck electrically before it bottlenecks thermally.

  • Stock Market Hype: Filter out financial valuations of specific PCB or MLCC manufacturers. Focus strictly on their production capacity, lead times, and technical specifications (like ESR and voltage ratings).

Frequently Asked Questions (FAQs)

Q: Why can't traditional silicon MOSFETs handle next-gen AI servers?
A: Traditional silicon reaches a physical limit in high-frequency, high-density environments (like 5.5kW+ PSUs). They generate too much heat and suffer from switching losses. Wide-Bandgap materials (SiC/GaN) offer lower on-resistance and zero reverse-recovery charge, enabling 97.5%+ efficiency in a smaller footprint.

Q: What is the "KV Cache memory trap" in local AI deployments?
A: When building local AI edge servers, engineers often calculate the VRAM needed for the model's parameters but forget the memory required for the context window (Key-Value cache). If you fill your unified memory entirely with the model, the system will crash when processing larger prompts.

Q: Why do AI servers require so many more MLCCs than traditional servers?
A: AI GPUs operate at very low voltages (sub-1V) but draw massive, instantaneous spikes in current (hundreds of amps) depending on the token workload. High-capacitance MLCCs must be placed adjacent to the GPU to act as rapid current buffers and prevent system failure. A single Rubin rack requires roughly 600,000 of them.

Q: How are hyperscalers impacting the component supply chain for enterprise buyers?
A: Hyperscalers are buying up massive foundry capacity for high-end components. This creates a "two-tier" market where top-tier suppliers prioritize hyperscaler orders, leaving mid-tier enterprise buyers facing 24-to-40-week lead times and 10-15% price hikes.

Q: How can procurement teams bypass 35-week lead times for PMICs and WBG devices?
A: Buyers must shift away from relying solely on direct franchised lines, which are backlogged by hyperscalers. Utilizing verified global supplier networks and independent distributors allows buyers to source allocated or excess inventory globally, significantly reducing lead times.
