Smd Components Outlook 2026: Supply, Lead Times, and Sourcing Options

Published: 21 July 2026 | Last Updated: 21 July 202614
The 2026 electronic component market faces a selective shortage driven by AI infrastructure and electric vehicles. While active ICs face lead times up to 55 weeks, commodity SMD passives remain stable at 12–20 weeks. This procurement guide details key trends in MLCCs and circuit protection, outlining actionable strategy solutions like dual-sourcing and flexible footprints to mitigate supply chain risks.

Quick Answer: The 2026 shortage is not a repeat of the 2020–2022 crisis. It is a highly selective supply crunch driven by AI infrastructure buildout and automotive electrification. Active ICs — MCUs, power management ICs, FPGAs — face lead times of 30–55+ weeks. In contrast, commodity SMD passives (standard MLCCs, general-purpose resistors) remain relatively stable at 12–20 weeks. However, specialty MLCCs, high-reliability resistors, and circuit protection components are tightening rapidly due to demand from AI servers and EV charging infrastructure. Procurement teams that treat the entire BOM as a single risk block will waste capital and miss critical windows. The winning approach: extend planning horizons to 18–24 months, integrate pin-compatible substitutions into the design phase, and secure passive-component buffers through vetted distributors.


Reader’s Decision Framework: Triage Your BOM Risk

Risk LevelComponent CategoryTypical Lead Time (Early 2026)Recommended Action
HighMCUs, Power ICs, FPGAs, High-Bandwidth Memory30–55+ weeksSecure 18‑month pipeline; qualify alternates immediately
MediumHigh-capacitance automotive MLCCs, power inductors, TVS diodes, fuses12–28 weeksDual‑source now; lock in distributor allocations
LowStandard consumer-grade resistors, commodity MLCCs (0402/0603, X7R, C0G)8–20 weeksMaintain standard buffer stock; monitor for trend changes

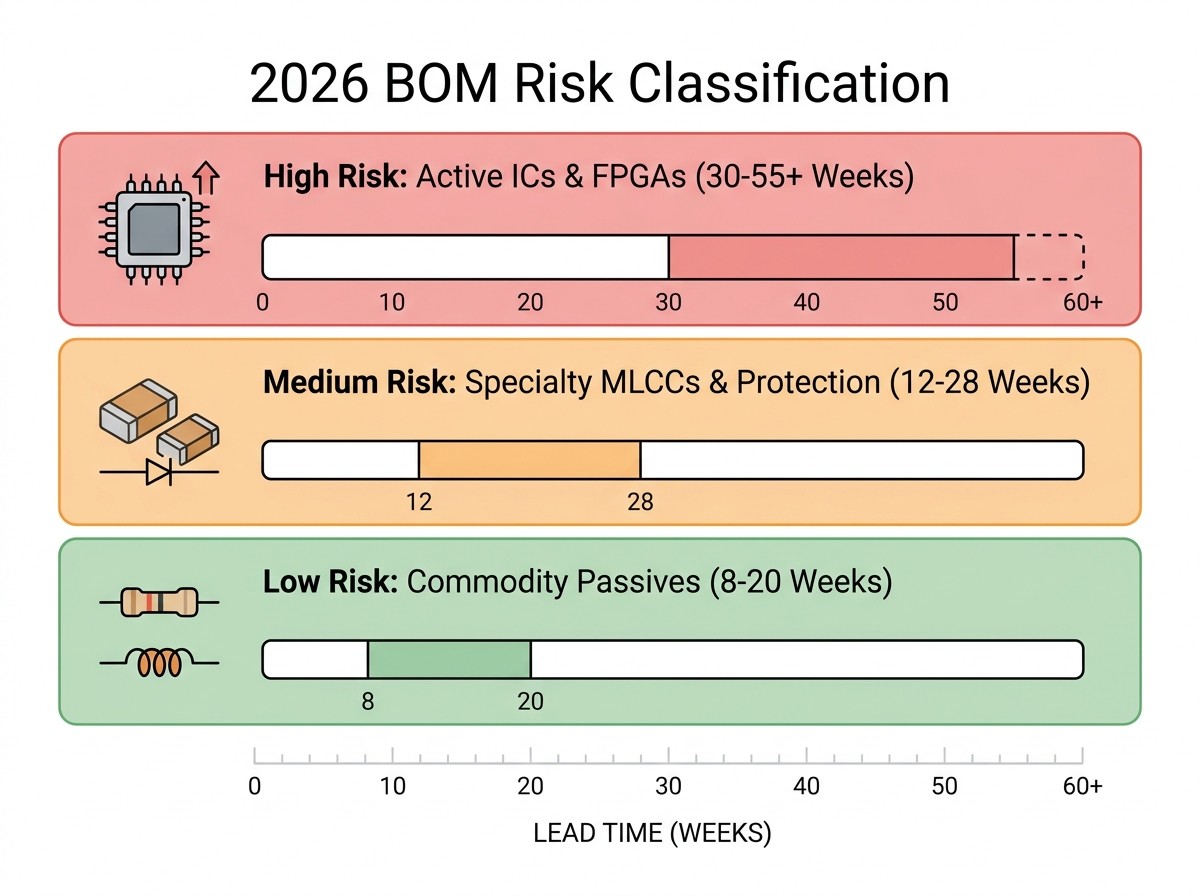

BOM Risk Classification Visual Guide

The 2026 Electronic Component Market: What’s Actually in Shortage?

The narrative of a “global component shortage” is misleading. What we are seeing is a concentrated demand shock from two sectors: hyperscaler AI infrastructure and automotive electrification.

Hyperscaler CapEx is absorbing production bandwidth. Combined capital spending on AI infrastructure by Amazon, Microsoft, Alphabet, and Meta is projected to reach $635–$725 billion in 2026, according to industry market reports. That level of investment monopolizes leading-edge foundry capacity — especially TSMC’s 3nm and 4nm nodes — and the advanced packaging (CoWoS) needed to assemble AI accelerators.

The hidden bottlenecks are not in the fabs. Real choke points are in raw materials and specialty substrates. Industry reports indicate that China accounts for a dominant share of the global refined gallium supply, with some estimates as high as 98%, and U.S. gallium prices rose sharply in early 2026 following tightened export restrictions, adding pressure to rising electronic component costs, according to market sources. Gallium is critical for GaN power chips used in AI server racks, and its shortage directly constrains the power-delivery chain — affecting the attached SMD components (inductors, MLCCs, circuit protection) that surround those chips.

At the same time, automotive demand remains structurally high. Every EV uses thousands of MLCCs and circuit protection devices, and 55% of TVS diode demand growth in 2026 comes directly from EV penetration and high‑voltage charging infrastructure, according to Business Research Insights.

Bottom line: The shortage is real, but it is selective. Know which components on your BOM are actually at risk.

The Next Chip Shortage: Warning Signs Already Appearing in 2026


Lead Time Breakdown: Active ICs vs. Passive Components

Lead times fluctuate weekly, but the following ranges are based on distributor reports and market intelligence from early 2026. Use them as planning benchmarks, not guarantees.

Estimated Lead Time (Q1–Q2 2026)Supply TrendRisk Level
Automotive MCUs (ST, NXP, Infineon): 40–55+ weeksExtendingHigh
Power Management ICs (PMICs, GaN drivers): 30–50 weeksTighteningHigh
FPGAs / CPLDs: 40–52 weeksStable, longHigh
High-Bandwidth Memory (HBM, DDR5): 26–52 weeksConstrainedHigh
Specialty / Automotive MLCCs (high temp, low loss): 12–28 weeksTighteningMedium
TVS Diodes, Fuses, Varistors (circuit protection): 12–24 weeksExtendingMedium
Standard MLCCs (X5R, X7R, consumer grade): 8–20 weeksStableLow
Thick Film Resistors, General‑Purpose Inductors: 8–16 weeksStableLow

Key insight: The gap between active IC lead times and passive component lead times is the largest it has been since 2021. While engineers wrestle with 50+ week MCU allocations, commodity passives can often be sourced within three to five months — but only if you plan ahead.


The MLCC market is splitting into two distinct lanes. Standard consumer-grade MLCCs (0402/0603, low capacitance, X5R/X7R) remain a buyer’s market. Supply is ample, pricing is competitive, and lead times hover in the 8–20‑week range.

Specialty MLCCs are a different story. The Asia-Pacific special MLCC market — high‑temperature, low‑loss, high‑voltage parts used in AI servers and EV inverters — is forecast to grow from $1.29 billion in 2026 to $2.72 billion by 2034 (13.4% CAGR) per Intel Market Research. This growth is outpacing capacity additions from top manufacturers. As a result, lead times for these parts are drifting toward the 20–28‑week mark, and spot pricing is rising.

If your design uses AI server‑grade MLCCs — for example, the high‑density power delivery stages in NVIDIA GB200 or Rubin racks — you should plan for extended lead times. UTMEL’s guide on AI server MLCCs explains why a single rack can require over 600,000 capacitors.

When evaluating substitution options, pay close attention to dielectric type and voltage rating. A good refresher is the ceramic capacitor basics article — it covers what to check when swapping X7R for C0G or vice versa.

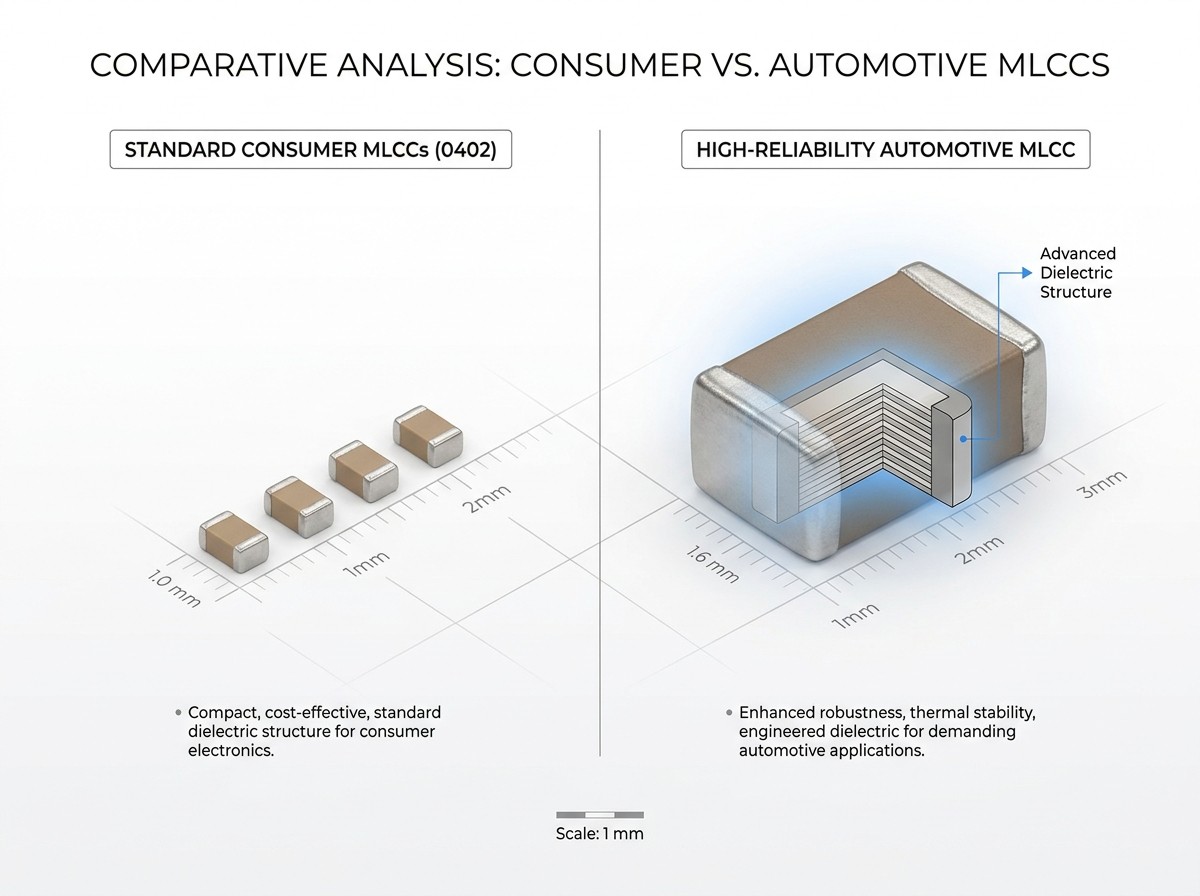

Standard vs. High-Reliability MLCC Form Factors

Circuit protection — TVS diodes, fuses, PTC resettable devices, varistors — is experiencing a structural tightening. The driver is twofold:

  1. Automotive electrification: High‑voltage EV charging and onboard power distribution demand more robust protection devices. As noted, 55% of TVS demand growth comes from EV infrastructure.

  2. Industrial and telecom surge requirements: Newer Ethernet standards and 5G base stations require tighter clamping voltages and higher energy absorption.

Lead times for many TVS diodes and fuses are now in the 12–24‑week range, and allocated capacity is common for automotive‑qualified parts. Buyers who treat circuit protection as a low‑priority, last‑minute BOM item are being caught short.

Tip: Before finalizing a board design, identify every protection component and verify its lifecycle status. Components near end‑of‑life (EOL) or on allocation will be harder to replace later. If your design uses a ballast resistor, review the ballast resistor classification and working principle to ensure your spec can be matched by an alternative.


Common Sourcing Mistakes in 2026

Mistake 1: Panic Buying and Double Ordering

When lead times stretch, the instinct is to order double quantities from multiple distributors. That behavior — logistics directors stockpiling in parallel — is exactly what turned a minor substrate pinch in Q3 2020 into a $210B global shortage in 2021. Don’t repeat the cycle. Instead, invest in accurate forecasting and single‑source commitments with vetted distributors.

Mistake 2: Treating the BOM as a Monolith

Applying a blanket “everything is in shortage” assumption wastes money on commodity passives while leaving critical active ICs under‑sourced. Use the triage framework above to allocate procurement effort proportionally.

Mistake 3: Ignoring Counterfeit Risk on the Open Market

When authorized channels show 50‑week lead times, buyers often turn to unvetted brokers. The risk of counterfeit or substandard parts spikes in such conditions. Always require traceability, Certificates of Conformance (CoC), and incoming inspection per ISO 9001 / AS6081. UTMEL’s fast RFQ process includes verification of supply chain authenticity.


4 Procurement Strategies to Manage Extended Lead Times

1. Extend Horizons to 18–24 Months

The era of placing orders for critical components four weeks before assembly is over. Provide your electronics manufacturing service (EMS) or contract manufacturer (CM) with rolling 18‑ to 24‑month demand forecasts. This allows them to secure factory allocations and book substrate capacity.

2. Design for Flexible Footprints

Hardware engineers should layout PCB pads so that pin‑compatible or form‑fit‑function equivalents can be dropped in without a board spin. Multi‑footprint layouts for MCUs and power ICs are a proven hedge. For resistors, standard case sizes and common values increase the pool of drop‑in replacements — the 2.2k ohm resistor color code guide is a handy reference when verifying alternates.

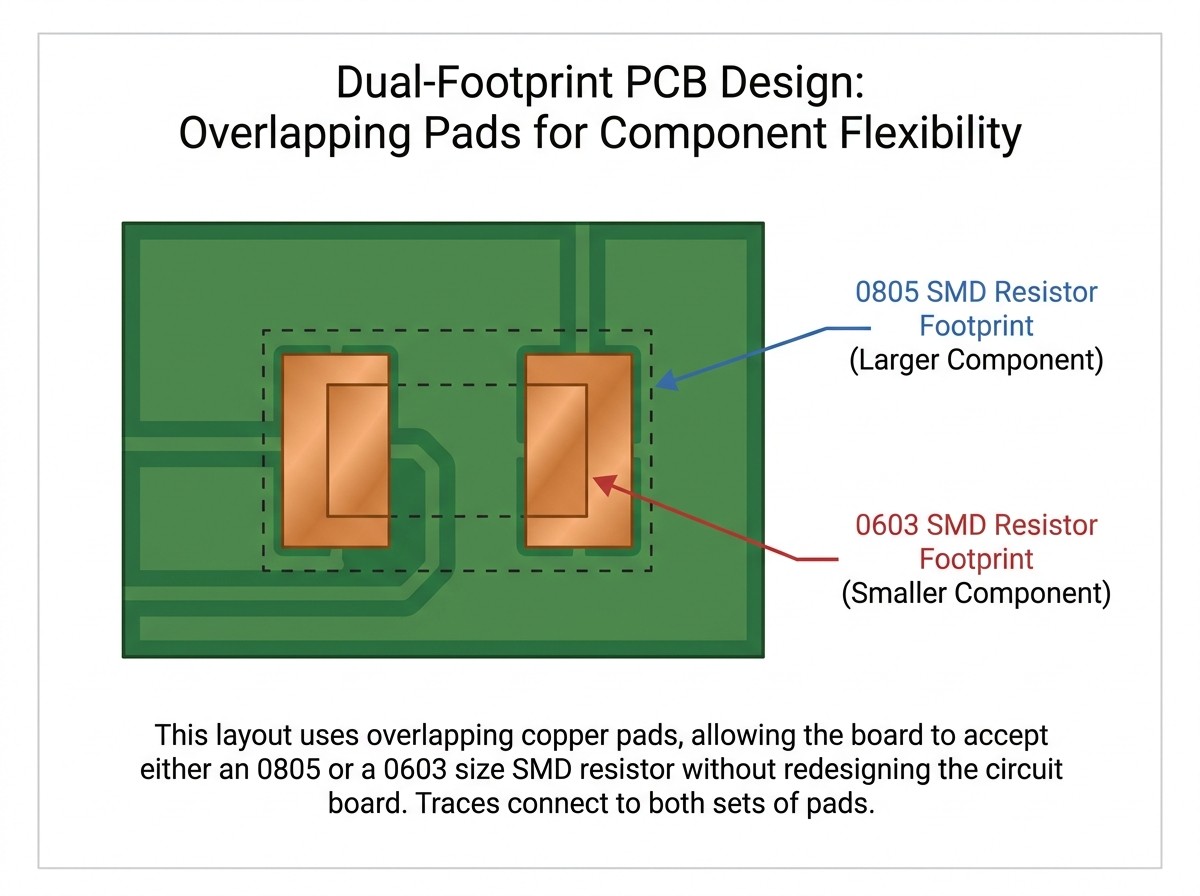

Flexible PCB Multi-Footprint Layout Design

3. Implement Dual Sourcing During Design

Qualifying a secondary source before production begins turns a 55‑week lead time into a simple purchasing switch. Engage with distributors like UTMEL early to identify form‑fit‑function equivalents for each BOM line.

4. Monitor Lifecycle and EOL Continuously

Many OEMs use parts with years left in the market until a sudden EOL notice from the manufacturer. Track lifecycle status (Active, NRND, EOL, Obsolete) at the part‑number level. Build strategic buffer stock for components flagged as “Last Time Buy” or in allocation.


The Role of BOM-Level Substitution and Reliable Sourcing

BOM‑level substitution is not about swapping parts blindly — it’s about making safe, verified replacements that keep production running while you wait for original parts.

When to substitute:

  • When the original part is on allocation with a 40+ week lead time.

  • When a pin‑compatible, electrically equivalent alternative is available from a reputable manufacturer.

  • When the application is non‑safety‑critical (or after proper re‑qualification for safety‑critical designs).

When a full redesign is required:

  • If the form factor changes (e.g., different package footprint).

  • If critical electrical parameters (voltage rating, capacitance value, temperature range) cannot be matched.

  • If the part is obsolete and no drop‑in exists.

UTMEL specializes in providing in‑stock capacitors, resistors, inductors, and circuit protection with real‑time lead‑time checks and fast RFQ quotes. Our BOM‑level substitution support helps engineers find equivalent parts from multiple manufacturers, reducing the risk of single‑source dependencies.


Final Checklist for Electronics Sourcing Teams

  • [ ] Verify lifecycle status of every active IC and critical passive component (NRND, EOL, allocated)

  • [ ] Cross‑reference dielectric material (X7R vs. C0G) and voltage rating before approving MLCC substitutions

  • [ ] Confirm traceability and Certificates of Conformance (CoC) for all open‑market purchases

  • [ ] Update procurement forecasts for memory, MCU, and high‑capacitance passive part numbers to an 18‑month horizon

  • [ ] Engage with a trusted distributor (like UTMEL) for passive-component buffer stock and substitution support

  • [ ] Design flexible PCB footprints and qualify alternates during the design phase — not after production starts


Frequently Asked Questions

Which SMD components are facing the worst shortages in 2026?
Active ICs — automotive MCUs, power management ICs, and FPGAs — have the longest lead times (30–55+ weeks). Specialty MLCCs for AI servers and EVs are tightening, while standard commodity passives remain relatively stable.

Why are electronic component costs rising?
Raw material constraints, particularly gallium and antimony, along with increased logistics costs and capacity prioritization for high‑margin sectors (AI, automotive), are driving cost increases across the supply chain.

How can I source allocated or obsolete SMD components safely?
Work with a franchised or vetted distributor that can supply traceable, certified parts. Avoid unvetted brokers. Use BOM‑level substitution to find form‑fit‑function alternatives from different manufacturers.
